Monday 13th AprilJerry finishes the anciliary wiring and closes the last wall in the shower room of No.5, then makes a start on chipping out the concrete around 4" waste pipe for the shower drain. | Monday 13th AprilGus recruits a new joiner, Kevin, to help speed the work along. He immediately sets to work on the door stops and facings in No.6. |
|
Monday 13th AprilOutside Brian has time to apply the final base coat to some of the walls before he heads off to Newcastle! | Tuesday 14th AprilJohn & Gavin return and set about digging up the road then laying the pipes to the main disconnecting manhole. We receive good news - Scottish Water have approved our water & sewerage for connection within the next 14 days (watch this space). |
|

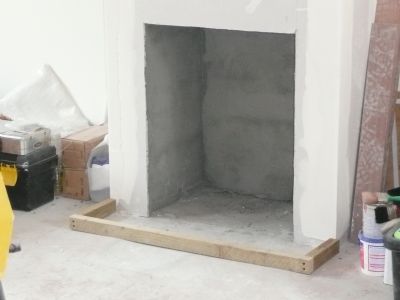

Tuesday 14th AprilThe shower drain is finished and ready for the tilers. Jerry then creates battens for the shower room floor and both hearths, ready for screeding in the morning. | Wednesday 15th AprilHearths & shower room floor duly screeded. |
|
Wednesday 15th AprilWater pipes (insulated) and telephone cables installed into the houses alongside the electricity and waste pipes. | Wednesday 15th AprilJohn & Gavin complete the services groundworks for now. They will be back to close the road once Scottish Water have made good the water connection. |
|
Thursday 6th AprilKevin fits the handrail and spindles to the stairs in No.6. | Friday 17th AprilThe joiners make a start on the engineered wood flooring in the master bedroom. |
|
| |
|
