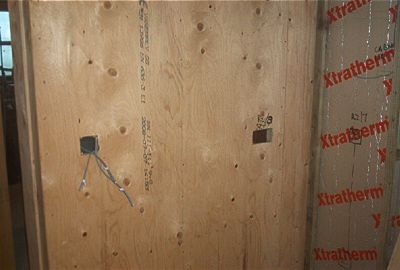

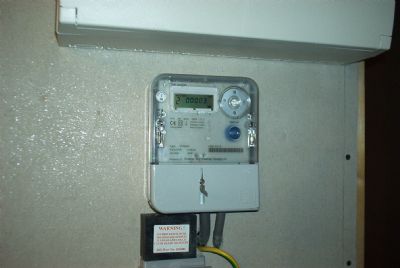

Monday 8th DecemberThe consumer units are connected to the meters - we have power! Jerry & John complete the ground floor lighting and thermostat wiring circuits for No 6, then make a start on No. 5. John is off back home tomorrow so progress will be a bit slower from now on. | Tuesday 9th DecemberMore wiring - the lighting circuits are completed and the first ring circuit in No. 5 started. |
|
Wednesday 10th DecemberA day of deliveries as we receive 10 tons of building sand, the pre-cast corner stones (above) & lintels, 66 sheets of chipboard flooring and half a dozen bags of cement. This will hopefully allow us to screed the upper floors on Friday and fit the floorboards before the screed sets. | Thursday 11th DecemberMore deliveries - this time 924 concrete blocks, enough to make a good start on the outside of the building on Monday (weather permitting). Inside the wiring of the gound floor of No.5 is finished. |
|
Friday 12th DecemberThe roof is finally finished (apart from around the missing chimneys). | Friday 12th DecemberJerry continues with the wiring in No.6 and is only halted by the arrival of Scottish & Southern Energy to change the meters to off-peak versions - as ordered! |
|
| |
|
| |
|
