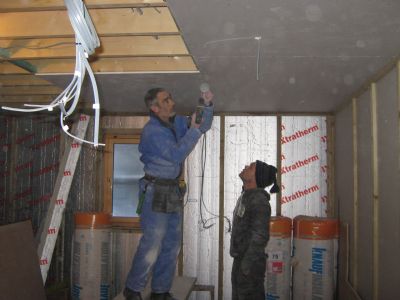

Monday 2nd FebruaryThe joiners have completed the plasterboarding in No 6 upstairs and move downstairs. | Tuesday 3rd FebruaryMeanwhile Brian works on the chimney in No 6 completing the render of the chimney breast in the lounge. |
|

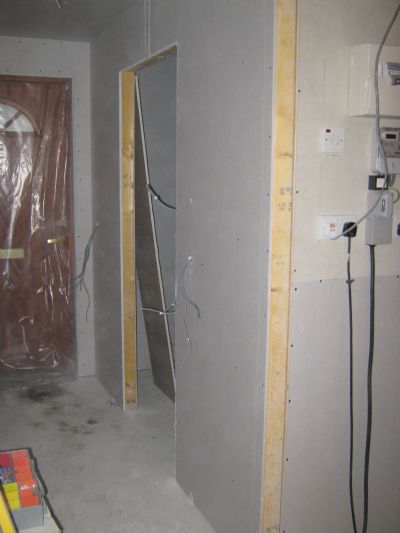

Tuesday 3rd FebruaryGus and Jonathan finish plasterboarding the shower room downstairs in No 6, so are ready to move next door to No 5. | Wednesday 4th FebruaryJerry opens up the shower room floor to make way for the shower drain fitting. |
|
Thursday 5th FebruaryDespite the snow which prevents the builders working outside, the joiners make good progress in finishing the upstairs external plasterboard. They then make a start downstairs in No.5 - Gus is supervising whilst keeping his hands warm!. | Thursday 5th FebruaryWe also recently took delivery of the baths; this is the one in situ in the upstairs bathroom of No.6. |
|

Friday 6th FebruaryMore snow today, but the decorator arrives on site and makes a good start on the taping in No.6. Meanwhile the joiners carry on with the plasterboard and partitions next door. | Friday 6th FebruaryAlso in No.6 Brian breaks through the ceiling with the chimney - a nice inside job in such inclement weather!! |
|
| |
|
