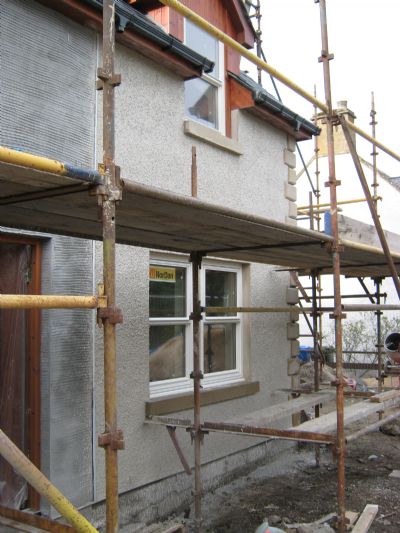

Monday 16th MarchInside, Neil applies the tanking (waterproofing) to the shower floor and grouts the tiles on the entrance halls; Jerry nears the end of the electrical 2nd fix in No. 6 and outside Brian & Shug start on the white cement ingoes of the windows and doors at the front of the houses. | Tuesday 17th MarchWe get our first finished outside wall - Brian harls the front panel of No.6 as well as 2 sides of the chimney. |
|

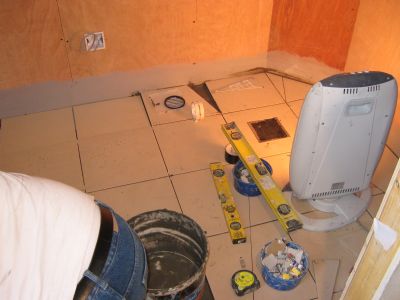

Tuesday 17th MarchNeil starts on the shower room floor tiles, making sure there is adequate fall towards the drain. | Wednesday 18th MarchNeil completes the floor tiles - the laid to fall area in the shower room looks particularly good. |
|

Thursday 19th MarchThe front of the house is fully harled - Brian also nears completion of the scratch coat at the rear and Jerry completes the terminating and testing of the electrical circuits. A good day on site! | Friday 20th MarchToday we welcomed back the joiners. Jonathan made light work of completing the insulation and flooring in the loft while Angus and Jerry made a start on fitting out the kitchen. |
|
| |
|
